Individual Assignment

✅
Design and document the system integration for your final project

Table of Contents

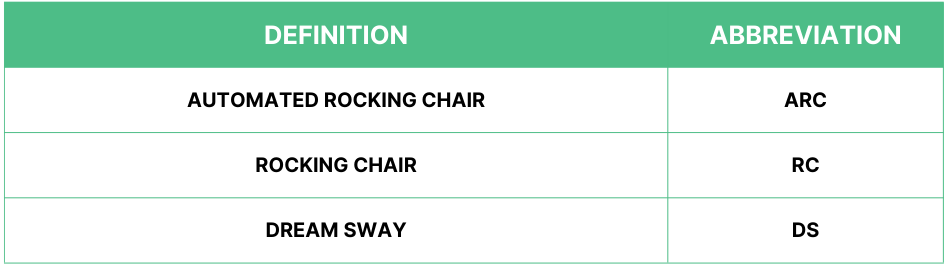

Abbreviation

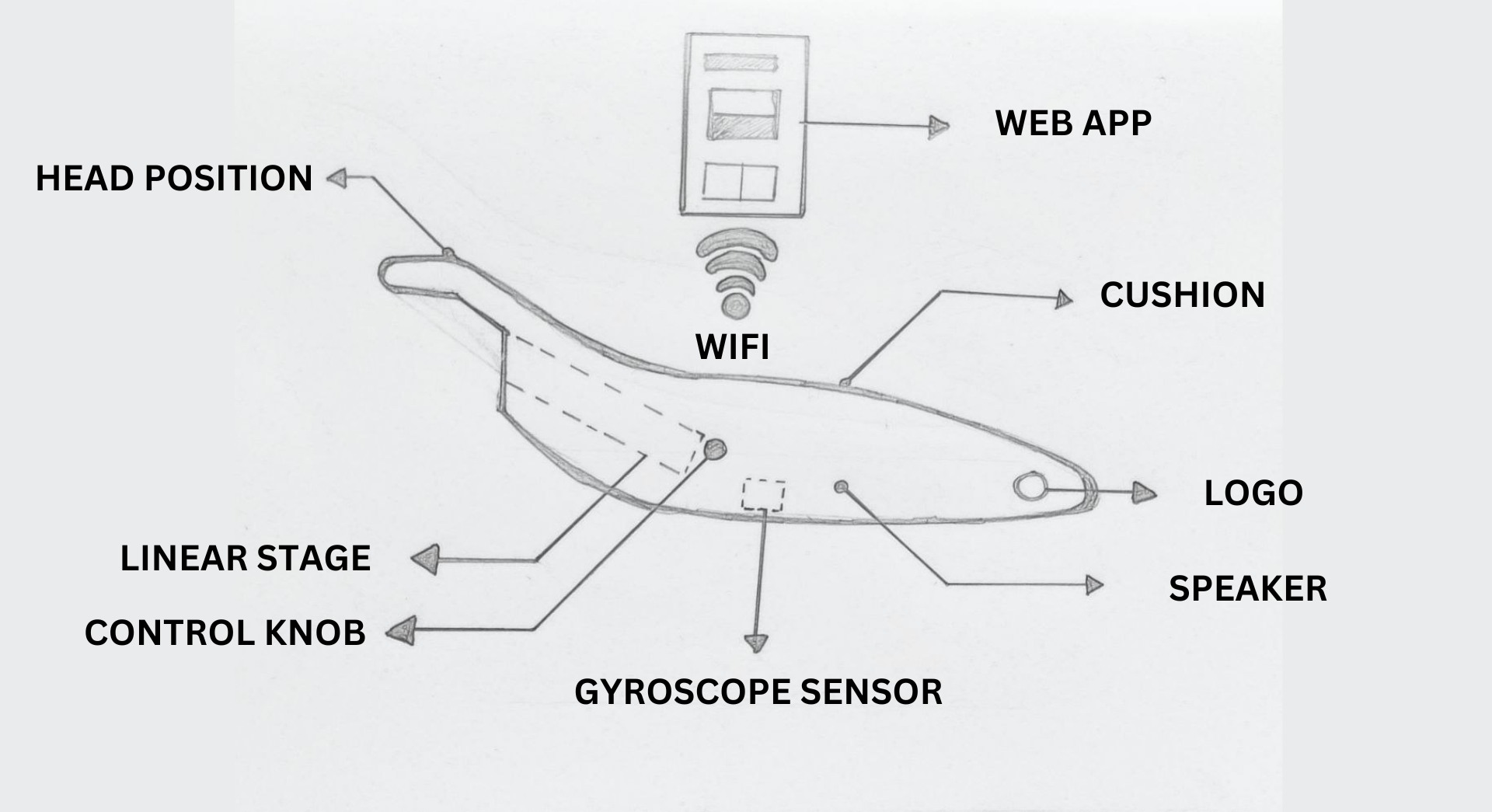

Final Project Sketch

Final Project Features

✅
DC servo mechanism controlled by servo
✅
Oscillation control knob
✅
ESP32: WIFI and Bluetooth capability
✅
User flexibility feature
✅
Stress reliefer
✅
Audio integration feature

Production Method

🛤️

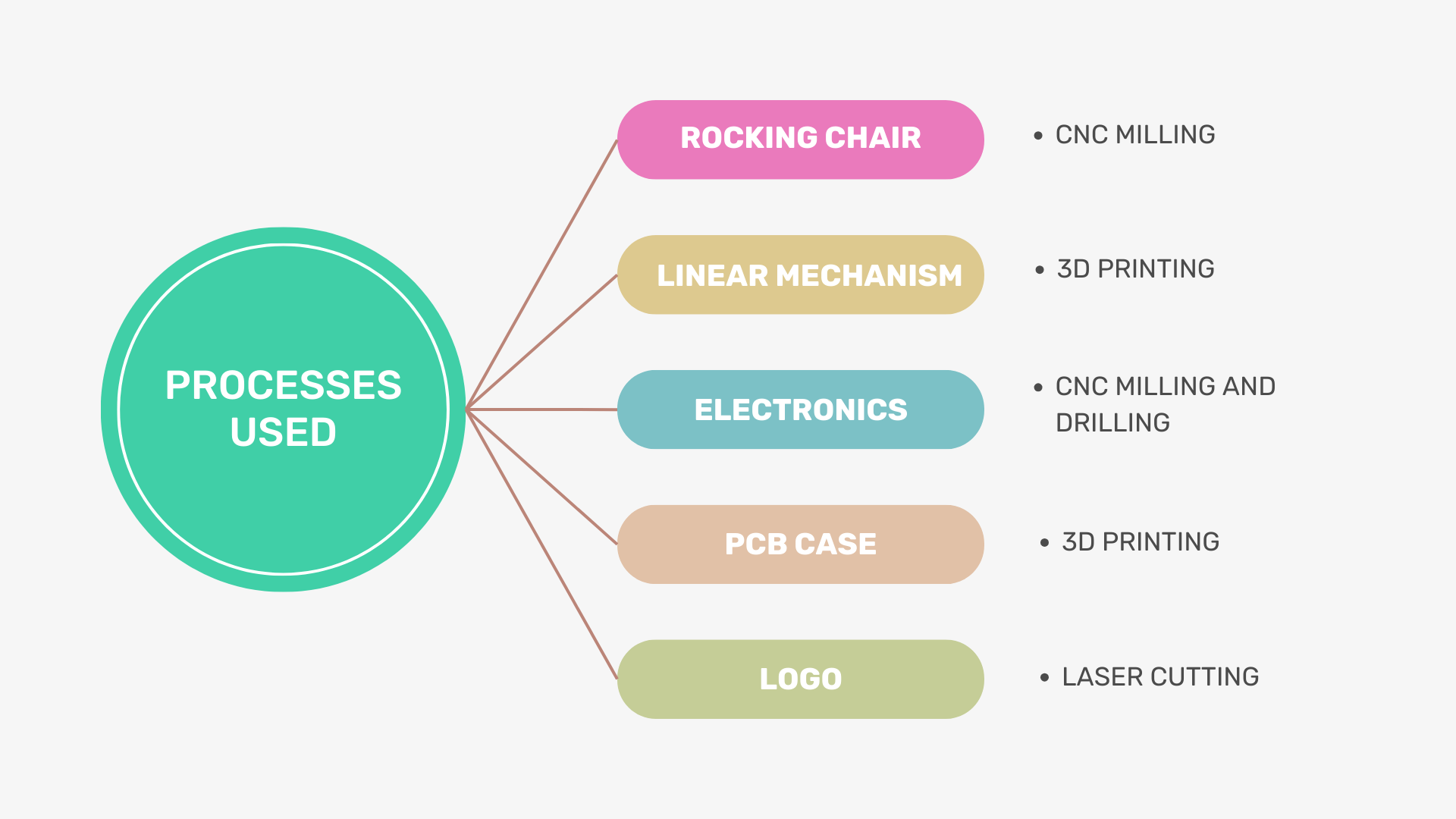

The image below illustrates the processes used in the final project.
🛤️

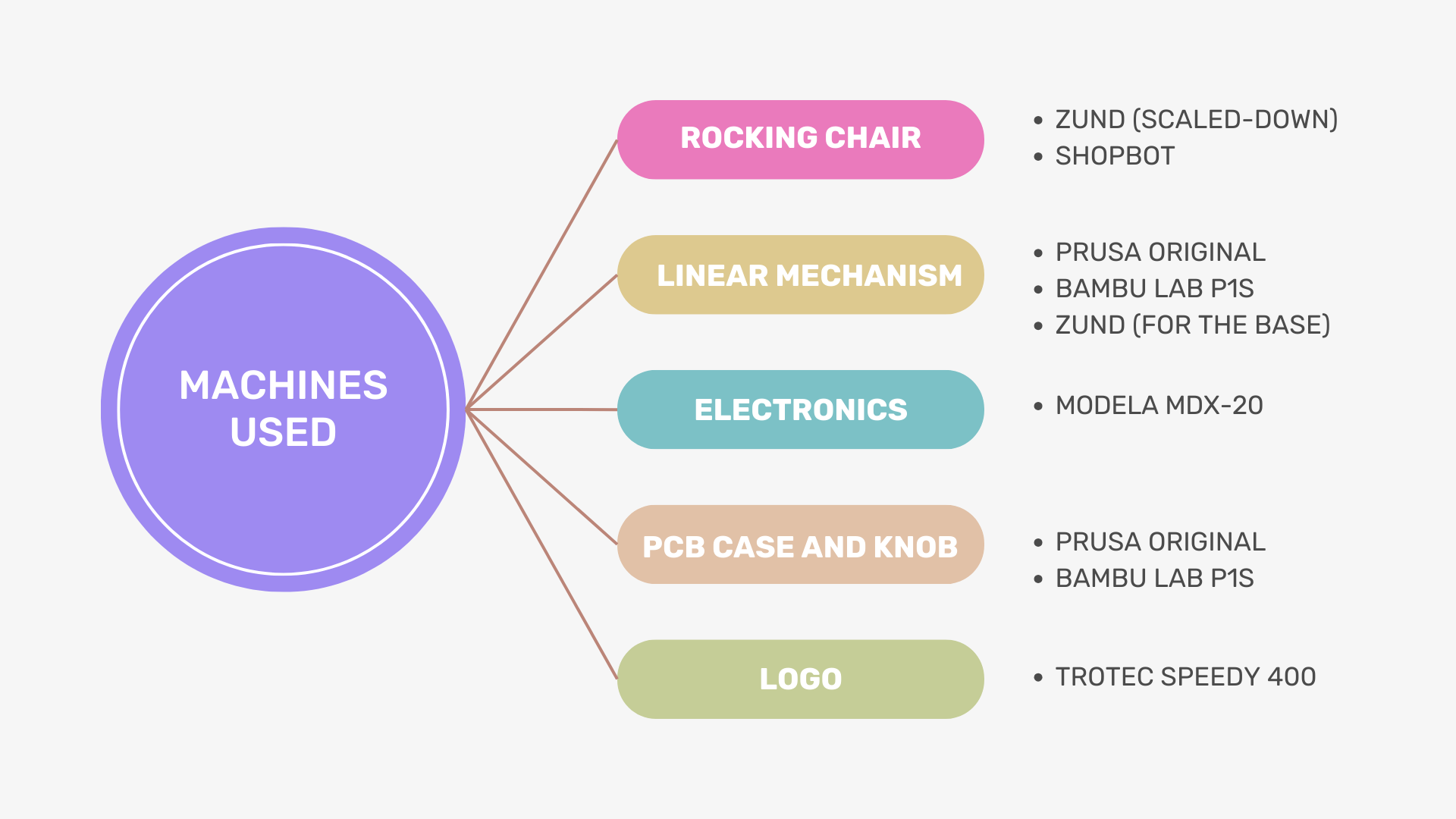

The image below illustrates the machines used in the final project.

RC Production

🏗️
Define the design and dimensions of the RC furniture.
🏗️
Create a 2D/3D model of the furniture using CAD software.
🏗️
Export the design files to a format compatible with the ShopBot.
🏗️
Use CAM software to generate toolpaths, ensuring settings are optimized for plywood cutting.
🏗️
Choose high-quality plywood sheets suitable for furniture.
🏗️
Securely fix the plywood sheets onto the ShopBot bed.
🏗️
Load the toolpath files into the ShopBot controller software.
🏗️
Execute the cutting process, monitoring the ShopBot to ensure precision and safety.
🏗️
Sand the edges of the cut pieces to remove splinters and roughness.
🏗️
Assemble the pieces.
🏗️
Inspect the completed RC furniture for any defects or adjustments needed.

3D Printing Linear Mechanism:

🏗️
Define the requirements and constraints of your linear mechanism.
🏗️
Use CAD software such as Fusion 360 to create a detailed 3D model of the mechanism, including all components such as sliders, rails, and any mounting points for motors or sensors.
🏗️
Select appropriate filament materials based on the mechanical properties needed.
🏗️
Use slicing software to convert the 3D model into a format compatible with the 3D printer.
🏗️
Print the parts using a 3D printer
🏗️
Remove any supports and smooth out rough edges using tools like sandpaper, files, or chemical treatments.
🏗️
Assemble the printed parts.
🏗️
Conduct thorough testing to ensure the mechanism meets all design requirements and performs reliably under expected operating conditions.

Electronic Circuit and PCB Production:

🏗️
Create the schematic and design the PCB using KiCad.
🏗️
Mill the PCB and solder the components.
🏗️
Test the board and upload the program.

Logo For the ARC

🏗️
Define the design and dimensions of the logo.
🏗️
Use graphic design software to create the logo design.
🏗️
Export the design to a format compatible with the Trotec Speedy 400 (DXF).
🏗️
Import the file into Trotec JobControl software, adjusting the layout for optimal material usage.
🏗️
Choose an acrylic sheet of the appropriate thickness and color for your logo.
🏗️
Execute the cutting and engraving process, monitoring the laser to ensure precision and safety.
🏗️
Carefully remove any protective film from the acrylic pieces if present.

BOM

📢
I have listed the approximate cost and quantity of the components I will be using for this project below.

Rocking Chair

MaterialQuantityPrice
PLYWOOD1 sheet2300 INR

Linear Mechanism

Components QuantityPrice
ALUMINIUM EXTRUSION PROFILE0.5 m500 INR
ENCODER11000 INR
DC MOTOR133990 INR
MASS2500 INR
BELT1.5 m200 INR
T-NUT15225 INR
M5 BOLT1590 INR
M6 BOLT1060 INR

PCB

Components QuantityPrice
ESP321262 INR
MPU-60501100 INR
POTENTIOMETER114 INR
MOTOR DRIVER12500 INR
BUZZER115 INR
RESISTOR 1020 INR
CAPACITOR618 INR
LED39 INR
MOSFET624 INR
VOLTAGE REGULATOR242 INR
PUSH BUTTON224 INR

Final Project Schedule

🗓️

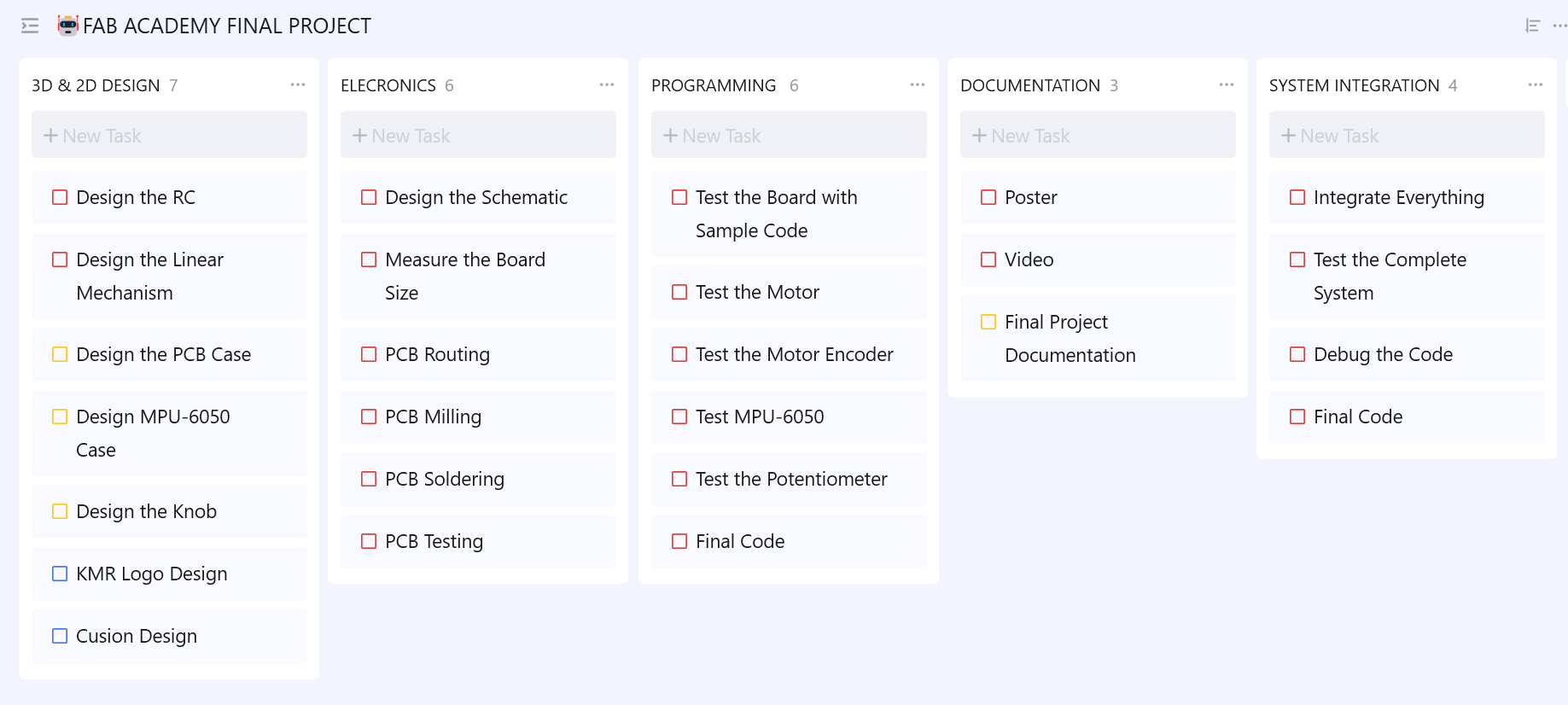

The Kanban chart of my final project is shown below
🗓️

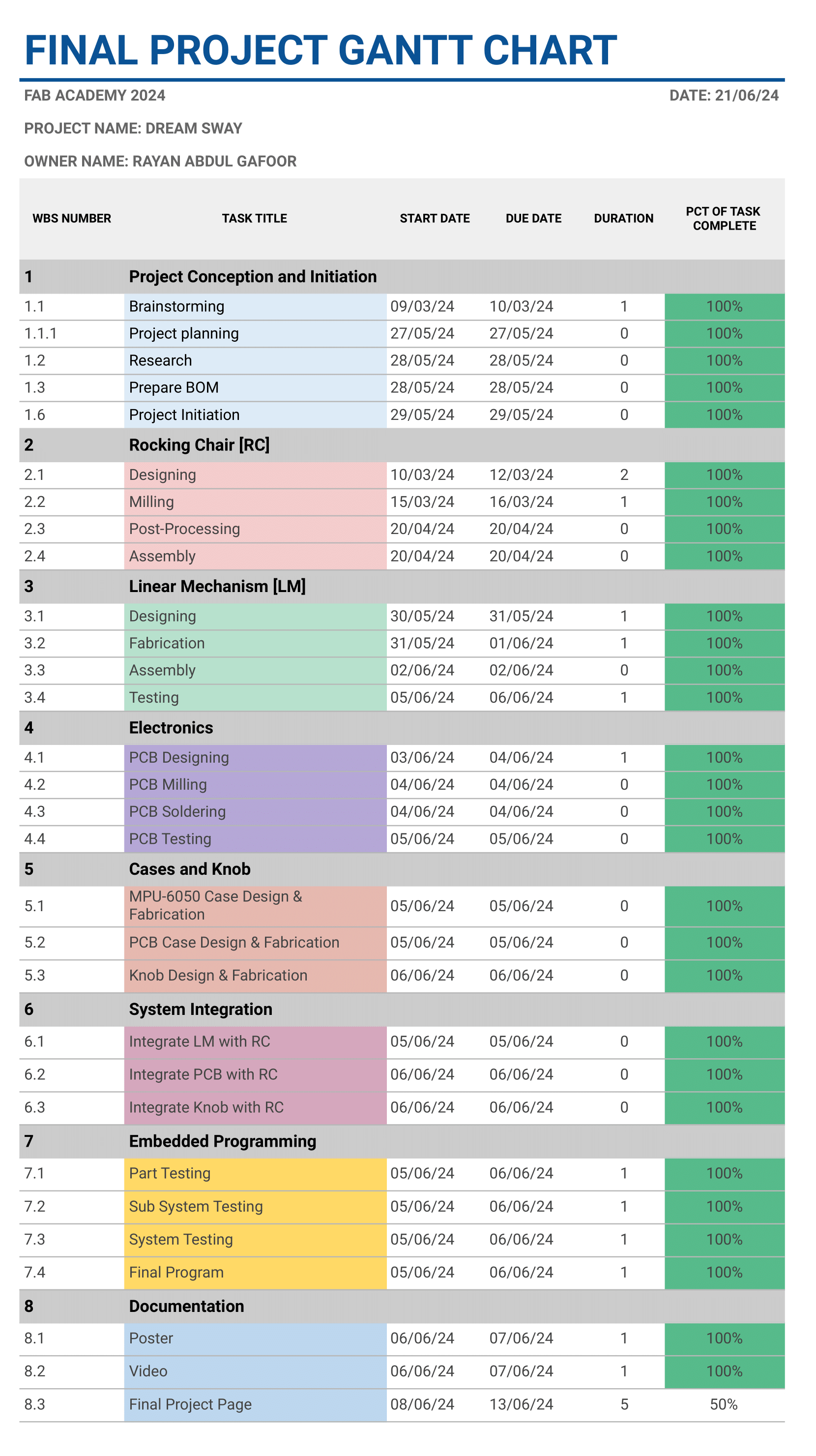

The Gantt chart for my final project is shown below. After completing my final project, I prepared this Gantt chart. Due to the dengue fever, I lost 10 valuable days of my final project. I was unable to complete this task before the final project. However, I have prepared schedules and timelines in my notebook. Later, I digitalized it.

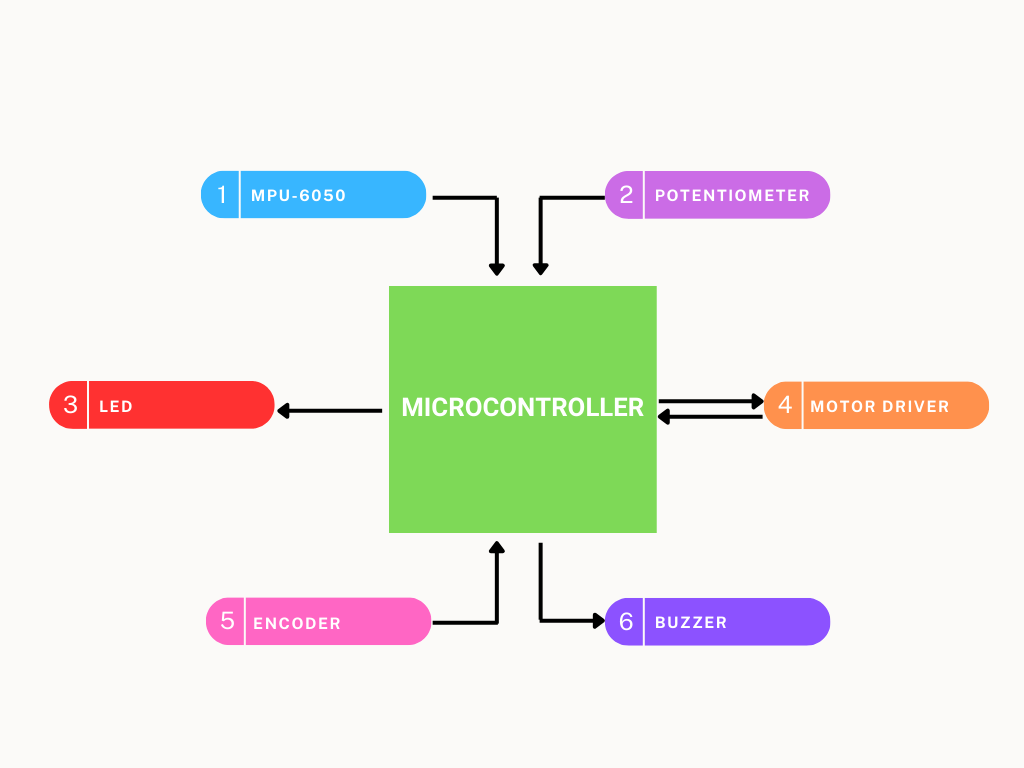

Final Project Block Diagram

🛤️
The image below illustrates the block diagram of the Dream Sway.

Final Project Mind Map

⏰

The image below illustrates the mind map of the Dream Sway.
⏰

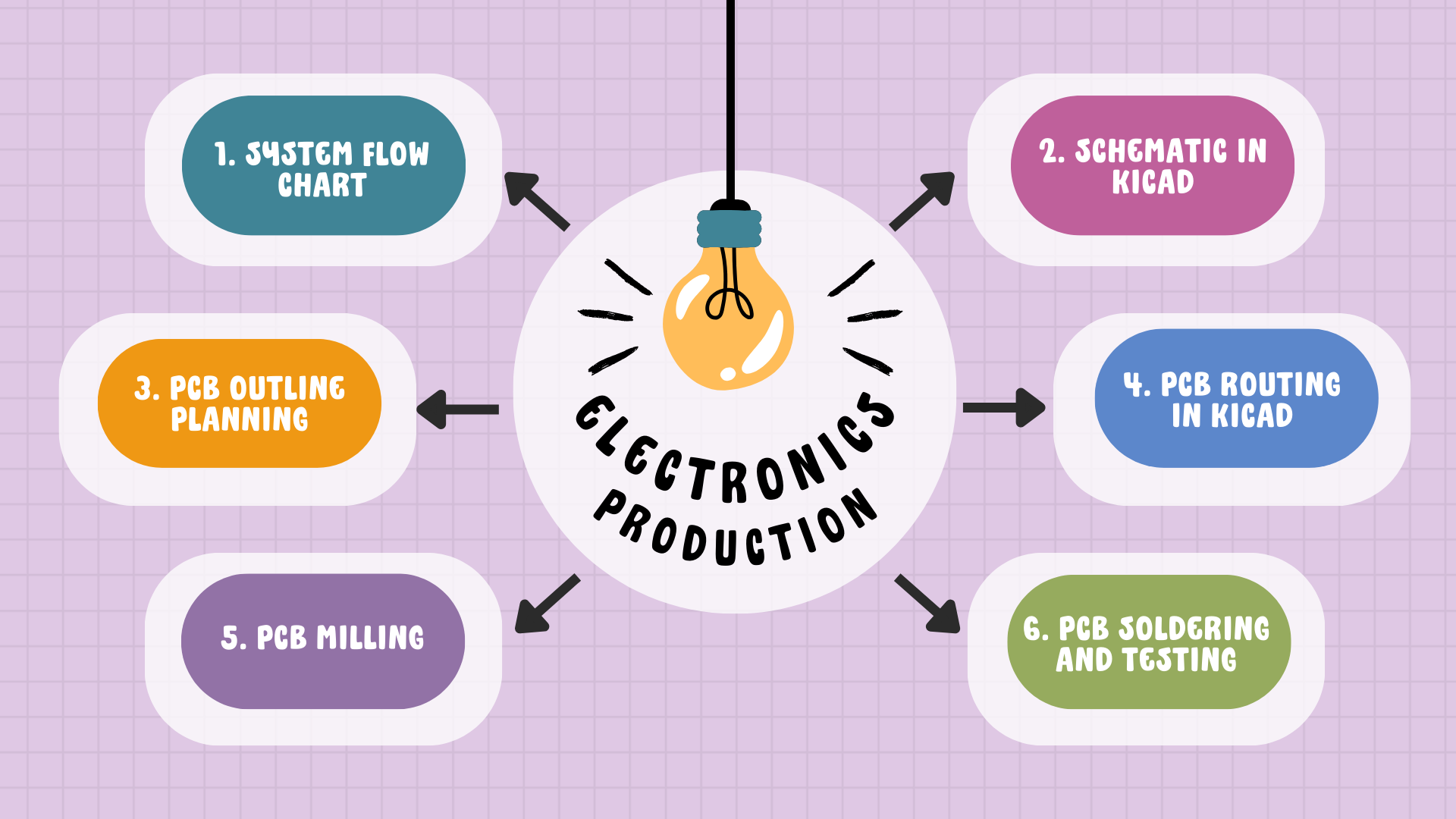

The image below illustrates the mind map of the electronics production process for my final project.

License

The work mentioned on this page is licensed under a Creative Commons Attribution-NonCommercial-ShareAlike 4.0 International License

Fab Academy © 2024 by Rayan Abdul Gafoor is licensed under Creative Commons Attribution-NonCommercial-ShareAlike 4.0 International
